Humber Bay Shores 320-Unit Tower Hydronic Riser Flush
A documented project record from Condo HVAC Repair Toronto. A 2008 Humber Bay Shores lakefront tower was quoted $800K+ for riser replacement by two prior consultants. Our chemistry-based diagnostic showed heavy mineral scale but zero corrosion. A 10-day chemical descaling restored loop pressure for $42,800 and extended riser life 15+ years.
By The Condo HVAC Repair Toronto Crew
Project Attributes
- Scope
- 10-day chemical flush of 18 vertical risers plus 2 Grundfos primary circulator pump replacements
- Price
- $42,800 CAD
- Payment
- 25% diagnostic approval, 50% flush completion, 25% at sign-off
- Lead time
- 3 weeks from signed contract
- On site
- 2 weeks (3 days diagnostic + 10-day flush + 2 days pump replacement)
- Client
- Property manager + condo corporation (2008 tower)
- Crew
- Elena Vargas (Ops Mgr) + 3 flush technicians + chemistry lab
- Equipment
- Original 18-stack vertical hydronic risers + Grundfos primary circulators
- Neighbourhood
- Humber Bay Shores
- Building
- 320 suites, 2008 construction
The Challenge
A 2008 Humber Bay Shores lakefront tower with 320 units served by 18 vertical hydronic risers was showing advanced scale buildup. The loop ran 20 psi below design pressure and primary pumps were working at 70 percent of nameplate to compensate.
Two prior consultants quoted riser replacement at $800K+. The condo corporation wanted a chemistry-based second opinion before committing to that capital expense.
Results
- Water hardness dropped from 420 ppm to 85 ppm (90% reduction).
- TDS dropped from 1,850 ppm to 420 ppm (77% reduction).
- Loop pressure restored to design within 24 hours of pump commissioning.
- $42,800 total vs $800K+ replacement quote = 95% capital preservation.
- Riser service life extended 15+ years with annual chemistry monitoring program.
How We Ran It
- 1

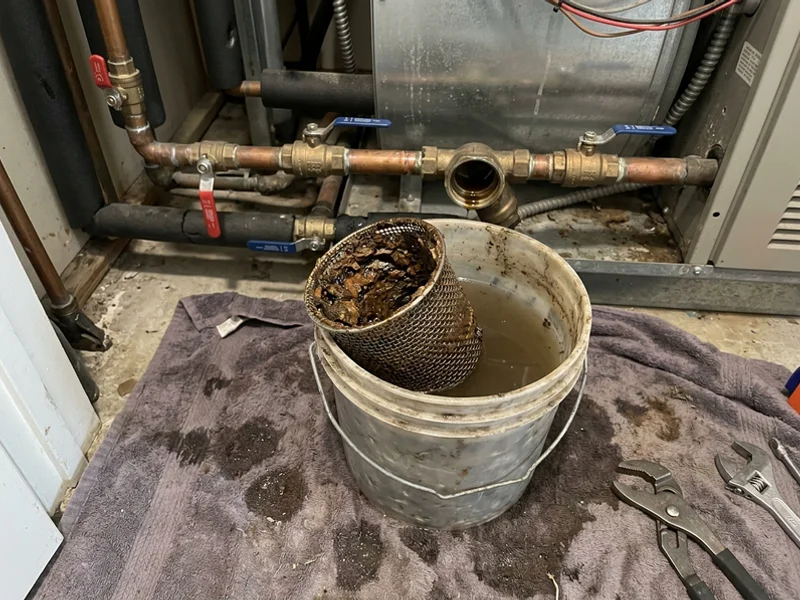

Three-day chemistry diagnostic
Loop water sampled at 6 points for TDS, pH, chloride, iron and hardness. Visual riser inspection at 4 access ports spanning the full height. Primary pump amp draw measured against nameplate.
- 2

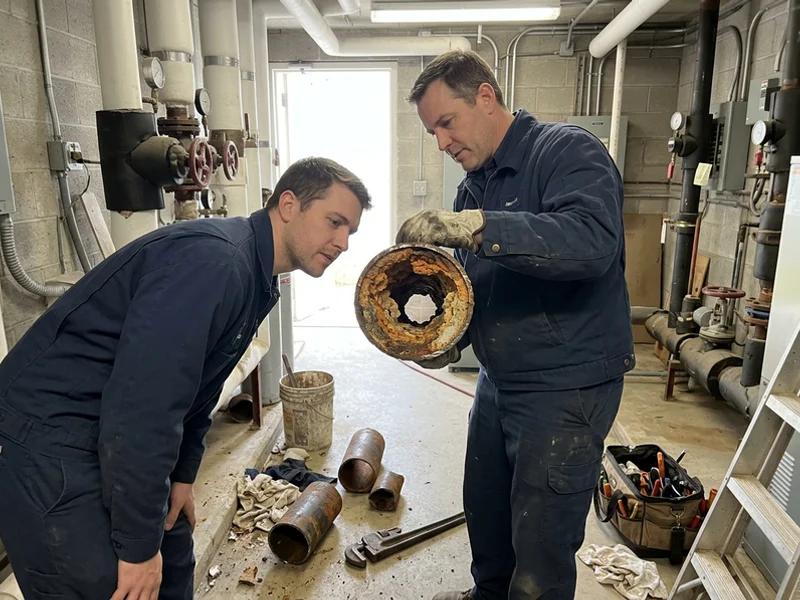

Diagnosis: scale, not corrosion
Water hardness 420 ppm, TDS 1,850 ppm, zero corrosion products, zero pitting visible. Risers structurally sound. Chemical descaling could restore loop capacity, no replacement required.
- 3
Ten-day inhibited flush

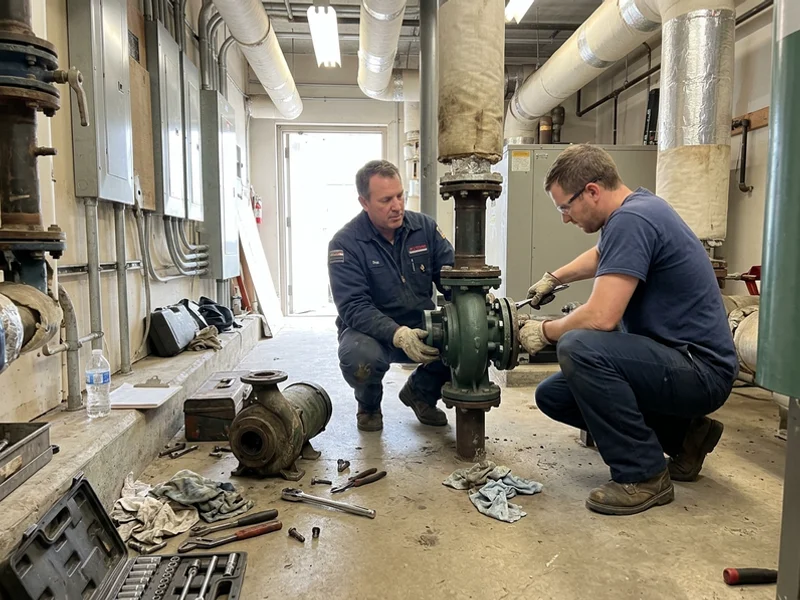

Full-building loop flushed over 10 days with inhibited descaler. Two Grundfos primary circulators replaced on condition basis. Pre- and post-flush chemistry documented at all 6 sample points.
- 4
Weekend pressure test and monitoring plan
Post-flush pressure test over a Friday-Sunday window with design pressure restored within 24 hours. Written 15-year chemistry monitoring plan delivered for ongoing scale prevention.
Project Photos
Click any photo to enlarge it.
"The scale report Elena delivered showed exactly where the loop was choking. The real win was proving the riser could run another 15 years instead of being replaced."
Marcus H., Property manager, Humber Bay Shores
More Condo HVAC Projects
Yorkville Yorkville 42-Unit Tower
Annual Fan Coil Service Program
- Scope
- 42 coil descales + 4 pumps + 11 valves
- On site
- 3 service nights across 2 weeks
- Crew
- Marcus Chen (Ops Mgr) + 4 technicians
- Equipment
- McQuay vertical fan coils, 2001 vintage
- Neighbourhood
- Yorkville
Mimico Mimico 180-Unit Lakefront
Building-Wide Fan Coil Replacement
- Scope
- Rolling fan coil replacement
- On site
- 14-week rolling install
- Crew
- Elena Vargas (Ops Mgr) + 2 crews
- Equipment
- Replacement vertical fan coils with ECM motors
- Neighbourhood
- Mimico
Downtown Markham Downtown Markham 24-Unit Mid-Rise
Water-Source Heat Pump Repair
- Scope
- Reversing valves + contactors
- On site
- 6 days over one season
- Crew
- James Kowalski (Ops Mgr) + 2 technicians
- Equipment
- Trane Axiom water-loop heat pumps
- Neighbourhood
- Downtown Markham
Planning Work Like This in Your Building?
Start with a free walk-through and readings in sample suites. Your board gets a written scope, per-unit pricing and a schedule before anyone commits.
- Written scope before work
- TSSA + Enbridge Red Tag + ESA + WSIB
- Written workmanship warranty
