Magic-Pak PTAC Replacement | King West

King West 65-Unit Furnished Rental Building Magic-Pak HWC to MGE Replacement

A documented project record from Condo HVAC Repair Toronto. A 1996 King West building running as a 65-unit furnished corporate rental was averaging 10-12 Magic-Pak failures per year. The replacement program ran floor-by-floor over 6 weeks with zero displaced guests, scheduled around real-time booking data.

By The Condo HVAC Repair Toronto Crew

$287,500 CAD 6 consecutive weeks on-site 65 suites
Magic-Pak MGE series PTACs staged in a King West corridor

Project Attributes

Scope
65 Magic-Pak HWC series PTACs replaced with MGE series over 6 weeks with zero displaced guests
Price
$287,500 CAD
Payment
15% deposit, weekly progress, 10% retention
Lead time
6 weeks (MGE manufacturer lead time)
On site
6 consecutive weeks on-site
Client
Corporate rental operator (1996 building)
Crew
Marcus Chen (Ops Mgr) + 3-tech crew + guest coordinator
Equipment
Magic-Pak HWC → MGE series + 12 louver reframes
Neighbourhood
King West
Building
65 suites, 1996 construction

The Challenge

A 1996 King West furnished corporate rental building was logging 10-12 Magic-Pak HWC failures per year across 65 suites. Each failure meant a displaced guest, a 2-3 day turnaround, and a potential liability on the booking platform.

The operations director needed a floor-by-floor replacement with zero displaced guests as a non-negotiable requirement.

Results

  • All 65 units replaced across 6 weeks with zero displaced guests.
  • 100% guest acceptance on 12 in-stay coordination requests.
  • Approximately 15% reduction in combined heating and cooling energy use post-replacement.
  • Zero commissioning failures, zero guest complaints during or after program.

How We Ran It

  1. 1

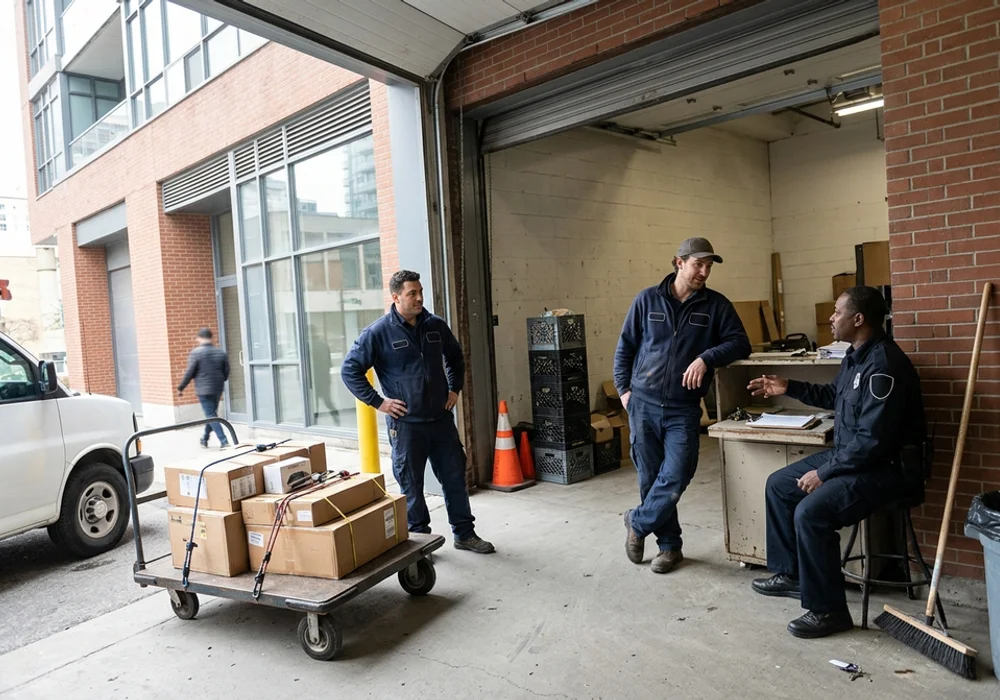

    Real-time booking coordination

    Operations team shared live booking data. 53 of 65 units were scheduled into natural check-out windows (3+ hour vacancies). The remaining 12 were coordinated directly with in-stay guests at mutually convenient times.

  2. 2

    Floor-by-floor rolling swap

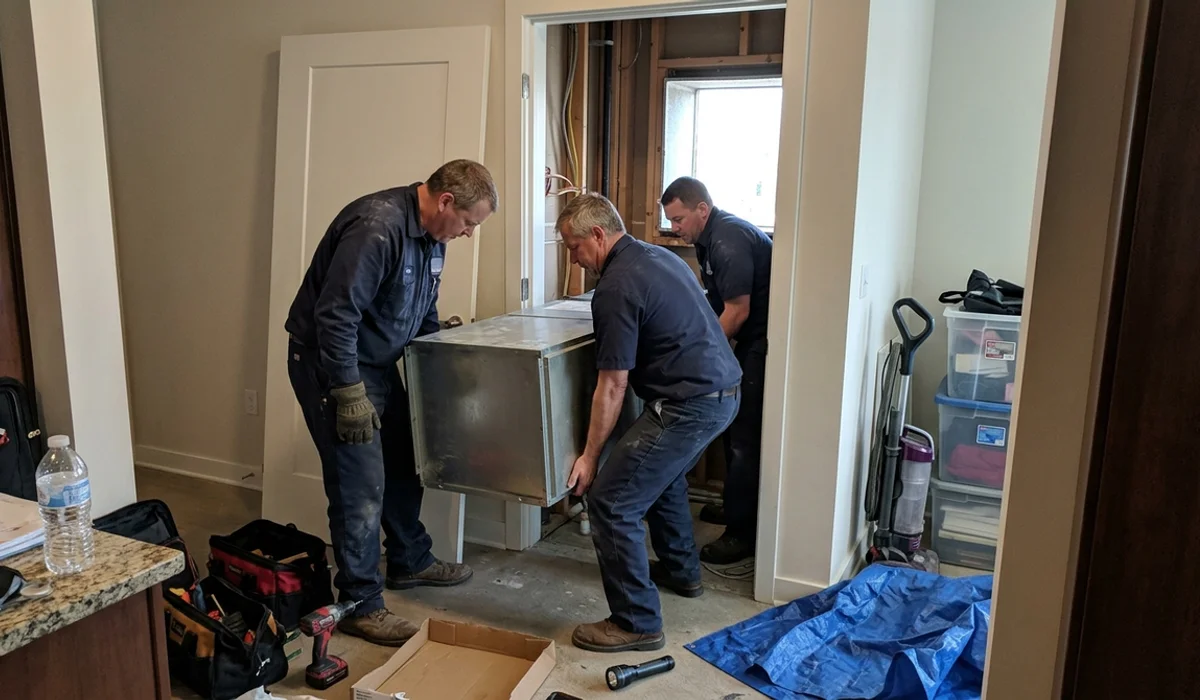

    Six weeks on-site, 11 units per week, working top-floor-down in 2-floor increments. 90-minute install window per suite with 4-technician crew.

  3. 3

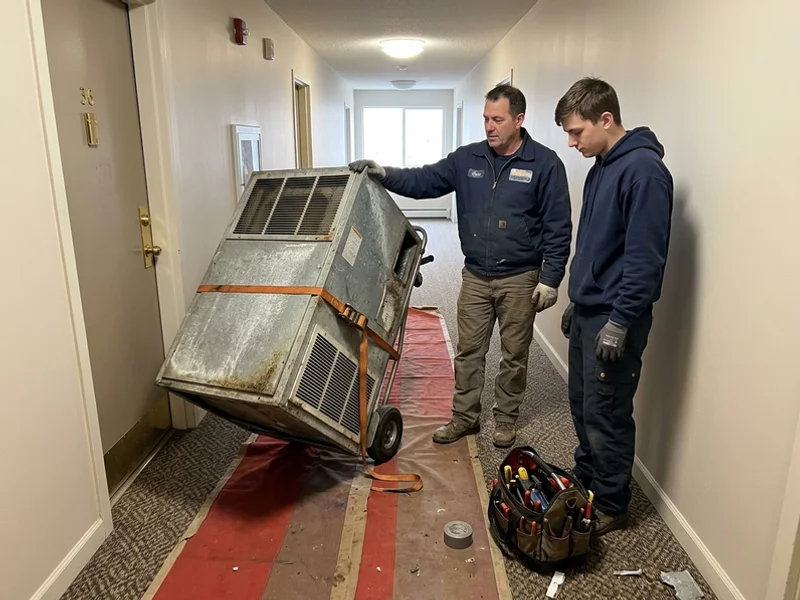

    Louver reframing for MGE profile

    MGE chassis required slightly wider exterior louver on 12 of 65 units. Louvers reframed with new weatherstripping as part of the swap sequence.

  4. 4

    New 24V thermostats and commissioning

    Every suite received a new 24V thermostat for MGE compatibility plus 15-minute heat and cool verification before sign-off.

Project Photos

Click any photo to enlarge it.

"Not a single guest was displaced. The MGE units run quieter than the HWCs ever did and our utility bills are down about 15 percent since the swap."

Daniel K., Operations director, corporate rental

24-Hour Condo Emergency Dispatch

Planning Work Like This in Your Building?

Start with a free walk-through and readings in sample suites. Your board gets a written scope, per-unit pricing and a schedule before anyone commits.

  • Written scope before work
  • TSSA + Enbridge Red Tag + ESA + WSIB
  • Written workmanship warranty
Call (437) 523-7002 Book $185 Diagnostic
